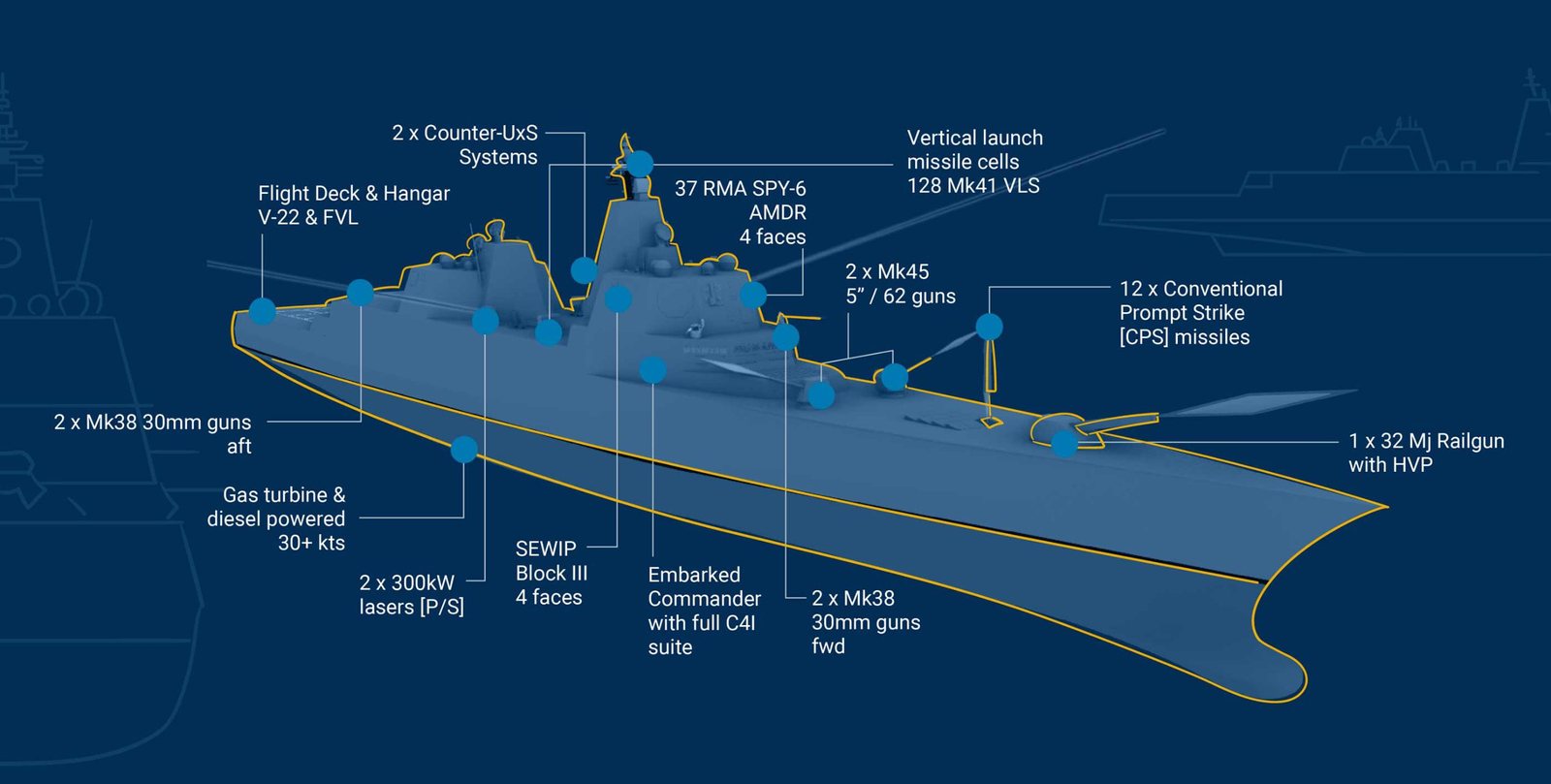

U.S. Navy graphic of the planned USS Defiant (BBG 1) and its main systems, released 22 Dec 2025U.S. Navy graphic · Public domain · Source
Planned hulls (FYDP)
3
BBG(X) 1–3 in PB27 FY27–31
First delivery
2036-08
PB27 SCN P-27 projection
Battle force category
LSC
Large surface combatant
Status
Planned
No contract awarded yet
Context
PB27 Shipbuilding Plan (May 2026) introduces the BBG(X) battleship as a high-end combatant within the "Golden Fleet" high-low mix, with three ships funded across FY28–FY31. The FY27 NDAA as passed by the House (H.R. 8800, Sec. 131) would limit construction pending a certification; it is not yet law. All dates below are projections from the PB27 SCN justification book (P-27) and are shown green (projected) in the data download.
Planned hulls
Hull
Name
Status
Budget FY
Contract award
Start of construction
Delivery
Commissioning FY
Builder
BBG(X) 1
TBD
Planned (PB27)
2028
2028-04
2028-08
2036-08
2036 (placeholder)
TBD
BBG(X) 2
TBD
Planned (PB27)
2030
2030-04
2030-08
2038-08
2038 (placeholder)
TBD
BBG(X) 3
TBD
Planned (PB27)
2031
2031-04
2031-08
2039-08
2039 (placeholder)
TBD
Data as of 3 Oct 2026 · Sources: PB27 Shipbuilding Plan (May 2026); PB27 SCN justification book P-27 (Apr 2026); H.R. 8800 (Engrossed in House) · Download data (CSV)
